Major Bridge P3 Project
Approved by the P3 Board in November 2020, the Major Bridge Public‐Private Partnership (MBP3) was established to accelerate the replacement and rehabilitation of major Interstate bridges. Under MBP3, and after a competitive procurement, PennDOT entered into a Pre‐Development Agreement (PDA) with a Development Entity, Bridging Pennsylvania Partners, LLC (BPP), to advance preliminary design work.
Under the PDA, BPP collaborated with PennDOT and performed pre-development work, including advancing designs; coordination with stakeholders, utilities, and railroads; obtaining or identifying required permits; assisting PennDOT in achieving NEPA approvals; performing site investigations; and conducting open book pricing; with the ultimate goal of submitting a package of the bridges to PennDOT for review and approval.
That approval ultimately led to a separate and new Design-Build-Finance-Maintain (DBFM) P3 contract between PennDOT and Bridging Pennsylvania Developer I (BPD1). The PDA was terminated in March 2023 and no additional P3 contracts will be procured under the agreement.
The PDA procurement strategy offered advantages over the traditional design-bid-build (DBB) delivery method, including:
- Proposer selection based on qualification, commercial pricing impositions, Project approach, and other proposal-based criteria (rather than solely on price) similar to a two-phase request for qualifications (RFQ) and request for proposal (RFP) Design-Build procurement.
- Efficient delivery whereby the Project design was advanced in the pre-development phase by BPP, allowing for the incorporation of the team’s means and methods of delivery, aligning to result in projects with a more definitive scope and content of work.
- Acceleration of schedule through a bundling of bridges into one separate and new P3 contract.
The MBP3 includes six bridges and reached contract execution (Commercial Close) on November 29, 2022, and Financial Close on December 22, 2022. PennDOT will repay the amounts financed by BPD1 through a one‐time mobilization payment, a one‐time milestone payment, and monthly availability payments subject to performance deductions over 35 years, beginning when construction is complete. The availability payments will be paid using a combination of federal and state funds.

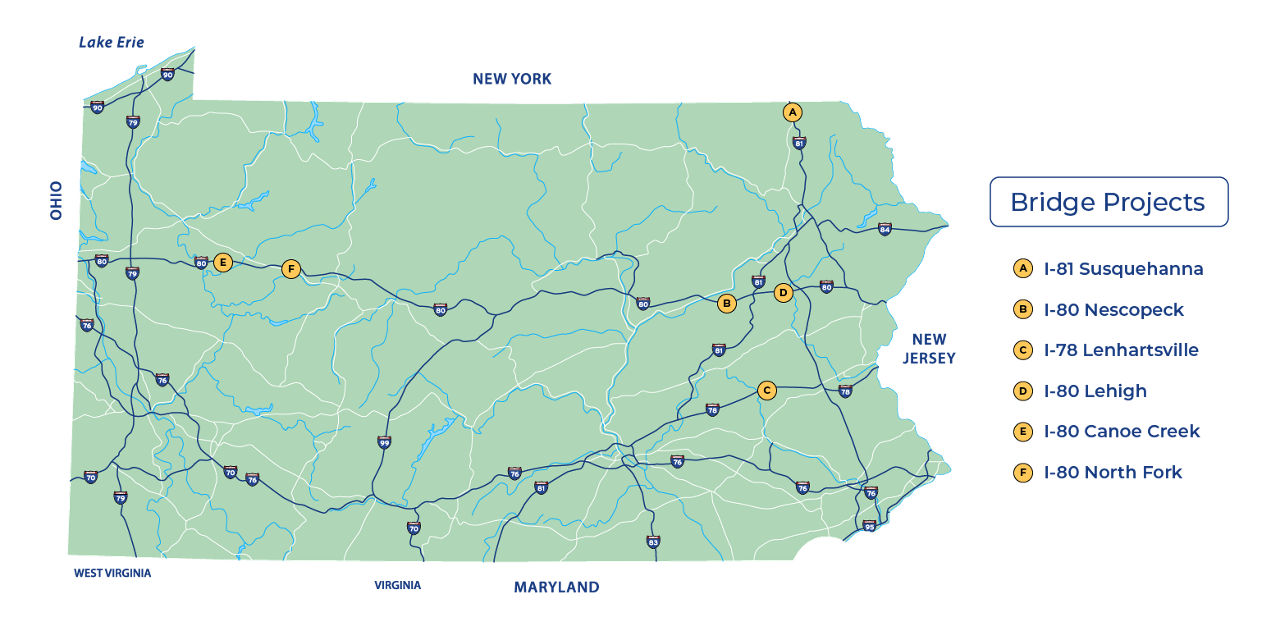

The 6 bridges included in the MBP3 DBFM contract include:
- I-80 Canoe Creek Bridges
- I-80 North Fork Bridges
- I-78 Lenhartsville Bridge
- I-80 Nescopeck Creek Bridges
- I-80 over Lehigh River Bridge Project
- I-81 Susquehanna Project
The Major Bridge P3 Project entered into the Final Design phase of the Design Build Finance Maintain term with the issuance of Notice to Proceed 2 on March 14, 2023. The final designs of all six Bridges were complete as of September 2024.
While the final designs were being completed, construction activities had begun on all six Bridges through the issuance of Limited Notices to Proceed (LNTPs). As major portions of each the Bridge designs were completed, (LNTPs) were issued in order to initiate limited portions of the construction work, when appropriate. An LNTP was issued for each of the six Bridges, with five of the six Bridges being authorized for full construction activities prior to the issuance of NTP3. The issuance of LNTPs exemplifies the design-build nature of the project that allowed construction to begin while portions of the design continue to be finalized.
As construction has started on each Bridge, the Development Entity has assumed maintenance responsibility within the project limits. Substantial Completion, meaning construction completion of all six Bridges, is scheduled for June 2028. After Substantial Completion, the Development Entity will maintain the bridges for a 35-year period.
Milestones
- Resolution Ratifying Action of the Public-Private Transportation Partnership Board (PDF)
- Press Release - Public-Private Partnership Board Approves Major Bridge Reconstruction and Rehabilitation Program
- Presentation - Major Bridges P3 Initiative Program Launch (PDF)
- P3 Bulletin - November 12, 2020 - P3 Board Approves Major Bridge Reconstruction and Rehabilitation Program
- PennDOT Major Bridge - RFQ
- Addendum No. 1 to RFQ - July 20, 2021 (PDF)
- PennDOT Major Bridges - RFQ Response No. 1 (PDF)
- PennDOT Major Bridges - RFQ Response No 2 (PDF)
- PennDOT Major Bridges -RFQ Response No. 3 (PDF)
- PennDOT Major Bridge - RFQ Response No. 4 (PDF)
- Press Release - PennDOT Invites Private Industry to Submit Qualifications for Major Bridge Public-Private Partnership Initiative
- P3 Bulletin Vol. 13 - PennDOT Issues Request for Qualifications for Major Bridge P3 Initiative
- Press Release - Three Teams Identified to Move Forward in Major Bridge Public-Private Partnership Initiative Procurement Process
- P3 Bulletin - September 20, 2021 - Three Teams Identified to Move Forward in Major Bridge P3 Initiative Procurement Process
- P3 Bulletin - November 12, 2021 - PennDOT Pathways Major Bridge P3 Initiative Presents Pre-Development Work Outreach Event with the Shortlisted Proposers
- Major Bridge P3 Instructions to Proposers (PDF)
- Major Bridge P3 Pre-Development Agreement (PDF)
- Bridging Pennsylvania Partners: Administrative and Legal Information for the PennDOT Pathways Major Bridge P3 Initiative - Volume 1 (PDF)
- Bridging Pennsylvania Partners: Administrative and Legal Information for the PennDOT Pathways Major Bridge P3 Initiative - Volume 2 (PDF)
- Bridging Pennsylvania Partners: Administrative and Legal Information for the PennDOT Pathways Major Bridge P3 Initiative - Volume 3 (PDF)

In PA, every $1 billion invested in bridge replacement or rehabilitation creates 10,493 jobs and generates $2.2 billion for our state's economy.
10,493 job-years is equivalent to a total of 10,493 years of individual employment over the life of the project.
Frequently Asked Questions
The Major Bridge P3 (MBP3) presented to the Pennsylvania P3 Board in November 2020 contemplated the replacement or rehabilitation of major interstate bridges through a progressive P3 delivery model under which PennDOT and a development entity would enter into a Pre-Development Agreement (PDA). The PDA focused on nine interstate bridges to be packaged for delivery through one or more Design-Build, Finance and Maintain (DBFM) agreements.
Of the nine bridges, six bridges were identified for Package 1:
- I-80 Canoe Creek Bridges
- I-80 North Fork Bridges
- I-78 Lenhartsville Bridge
- I-80 Nescopeck Creek Bridges
- I-80 over Lehigh River Bridge Project
- I-81 Susquehanna Project
PennDOT terminated the PDA for Package 2 on June 6, 2023. The process to allocate funding on the 12-year program to allow the I-83 South Bridge project to advance through the environmental, design and construction phases of the project has been initiated. To expedite this critical project, the department continues to seek Federal Discretionary funding so the project can be delivered earlier.
The project scopes and available funding for the remaining two bridges are being reviewed as part of our 2025 12-Year Program Update to determine a path forward:
- I-95 Girard Point Bridge Improvement Project; and
- I-79 Bridgeville Widening, Bridges and Interchange Reconfiguration Project.
When the MBP3 was approved, PennDOT planned to make annual payments to pay for the work and financing costs on these bridges using mandatory tolling, as was permitted by the Pennsylvania P3 law at the time. Since that time, Act 84 of 2022 amended the P3 law to eliminate mandatory tolling of existing free lanes. In August 2022, PennDOT chose to move the bridge projects in the MBP3 forward without tolling and pay for the project(s) using existing funds to make annual payments to the development entity.
PennDOT reached financial close on the six bridges in Package 1 – meaning the terms and conditions relative to the financing of the project were finalized – in December 2022.
Bridging Pennsylvania Partners LLC (BPP) was selected to deliver the Major Bridge P3 Program and formed the Development Entity, Bridging Pennsylvania Developer 1, LLC (BPD1) to deliver the first six bridges in the Program (Package One). Bridging Pennsylvania Partners (BPP) is led jointly by Macquarie Capital and Shikun & Binui as Lead Project Developer and Equity Members. Macquarie Capital and Shikun & Binui are international leaders in developing and delivering successful P3 projects.
The BPD joint venture (JV) consortium includes the design & construction expertise of FCC Construction Inc. (FCC) and S&B USA Concessions (SBA), based in Pittsburgh, Pennsylvania, who builds complex infrastructure projects and specializes in P3 and Design-Build projects. SBA is the construction arm of Shikun & Binui Ltd in the US, and is also the parent company of Joseph B. Fay, a subcontractor for this project. MBP3 was designed to make sure there were plenty of opportunities for Pennsylvania companies to share in the work done on the project. Other subcontractors include H&K Group, Inc., Kokosing Construction Company, Michael Baker International, SAI Consulting Engineers, and Wagman.
The six bridges in Package 1 will be delivered via the MBP3 and are currently in the final design phase or getting underway.
I-83 South Bridge was removed from the PDA on March 21, 2023. PennDOT terminated the PDA for Package 2 on June 6, 2023.
Overall estimated design and construction costs are approximately $1.5 billion for Package 1, prior to financing. On January 12, 2023, the Department paid the development entity a Mobilization Payment of $90,000,000 to account for costs of mobilization, related costs and to purchase materials.
Future payment to the development entity include the following:
- A Milestone Payment - The Department has agreed to pay the development entity a Milestone Payment equal to $50,000,000 when the Borrower completes 65% of the Design & Construction Work, but no earlier than September 1, 2027.
- Availability Payments – The Department agreed to make future availability payments to the development entity, annually, over a 35-year period. These payments will start with a partial payment (not a full year) in FY 2028 estimated at $48.0 million (when construction will be complete on all six bridges). In FY 2029, an estimated payment of $143.8 million will be paid to reflect the first full year's payment. From that point on, payments will change throughout the 35-year period based on the Consumer Price Index (CPI), reaching an estimated $177.7 million in FY 2063. The estimated final payment in FY 2064 is estimated to be $26.6 million.
Availability payments are regularly recurring, annual payments made to the development entity once construction of the bridges is complete. Availability payments are analogous to recurring mortgage payments.
The availability payment will be funded using a mix of state and federal dollars.
Construction is expected to take place from Summer 2023 through Summer 2028 with the first bridge to be completed Fall 2027. The first bridge to go into construction will be I-81 Susquehanna in Summer 2023.
Bridge | Anticipated Construction Start | Anticipated Bridge Completion |
I-81 Susquehanna | July 2023 | Summer 2028 |
I-80 Nescopeck | Spring 2024 | Fall 2027 |
I-78 Lenhartsville | Spring 2024 | Summer 2028 |
I-80 Lehigh River | Spring 2024 | Spring 2028 |
I-80 Canoe Creek | Fall 2023 | Fall 2027 |
I-80 North Fork | Spring 2024 | Summer 2028 |
